Generally Accepted Scheduling Principles (GASP)



 The Generally Accepted Scheduling Principles (GASP) are eight

over-arching tenets for building, maintaining, and using schedules as

effective management tools.



The GASP is concise and easily understood, yet set high expectations

for program management teams to develop and use schedules.

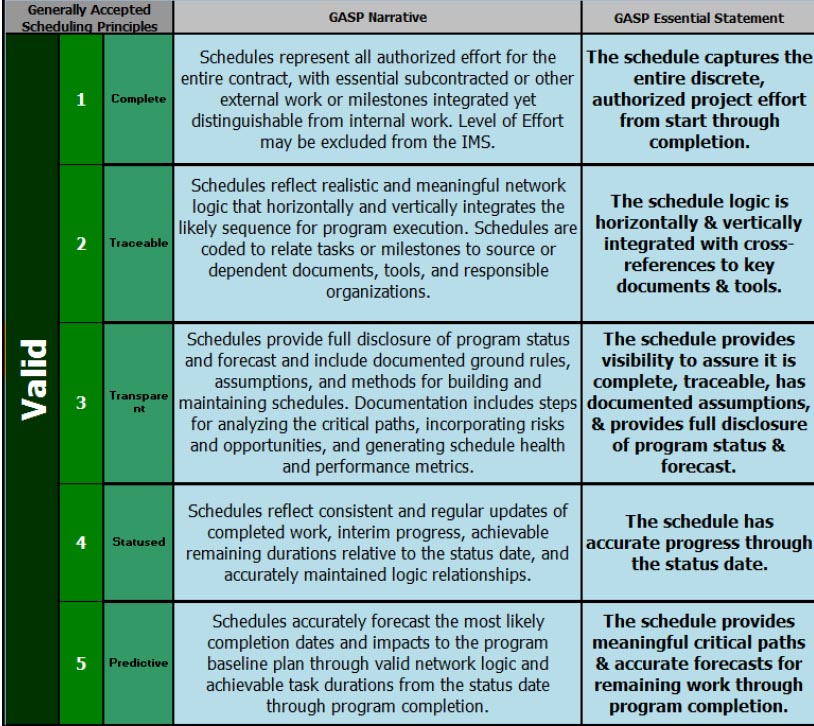

 The first five GASP tenets describe the requisite qualities of a valid

schedule; that is, one that provides complete, reasonable, and credible

 information based on realistic logic, durations, and dates.

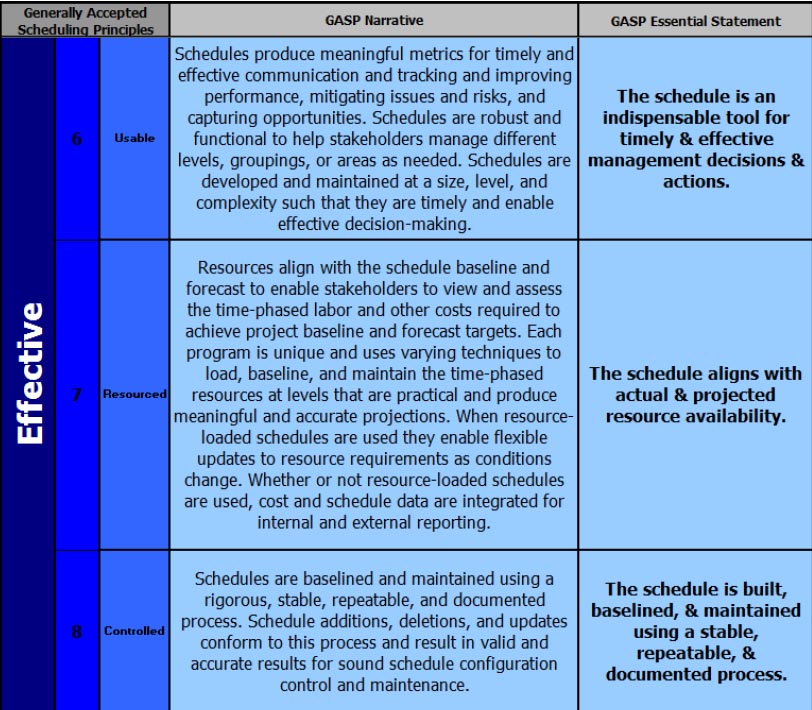

The latter three GASP tenets reflect increased scheduling maturity

that yields an effective schedule.



An effective schedule provides timely and reliable data, aligns

time-phased resources, and is built and maintained using controlled

and repeatable processes.



The GASP serves several purposes. First, they are high level tenets,

or targets, for sound scheduling. The GASP also serves as a validation

tool for the program team or organization to assess schedule maturity

or schedule areas needing improvement.



Lastly, the GASP can be used as a governance tool to assess new or

different scheduling approaches with objectivity and detachment.



 Achieving a GASP-compliant schedule indicates the schedule is not

merely healthy, but fit.



A healthy schedule is functional and meets minimum management

purposes, but a fit schedule is robust and dynamic.



 A fit schedule provides the program team with a program execution

roadmap of meaningful progress and realistic forecasts against a

resource-loaded performance measurement baseline.



Thus, meeting all eight GASP tenets demonstrates that the program

team builds and maintains the schedule with rigor and discipline so

that the IMS remains a meaningful management tool from program

start through completion.
